|  LINAC  March 17 - 24
                      Continue Preventative Maintenance on H.E. LINAC Klystron SystemsReturning LRF7 to 7835 ConditioningDriver Characterization on LRF5Anode Bulk Supply UpgradeMuCool Alignment Scheduled Today NTF Patient Treatment (M, W, & Th)  March 24 - 31
                      Continue Preventative maintenance on H.E. LINAC Klystron SystemsLLRF 9” Line Calibration on LRF4Modulator Characterization on LRF5Anode Bulk Supply UpgradeNTF Patient Treatment (M, W, & Th)  Completed Work
                      Cleaned L.E. LINAC Modulators & Rectifiers (LFR1-LRF5)Replace water fittings in Klystron Modulator De-Q’ing circuitReplaced Collimator between L.E. LINAC Tanks 1 & 2L.E. LINAC Water MaintenanceModified Chopper & Moved Quad for future MuCool operationsCleaned Filters on 8 Ion Pump PS’s45°/90° Magnet PS MaintenanceLLRF 9” Line Calibration on LRF5  Booster
                      Dump and Shielding installation completedQ805/Q806 re-installed, Septum in place
                      Need to align quads and septum before Beam pipe installationContinued Kicker installationLCW pipe for corrector upgrade nearly doneORBMP magnet/Girder work delayed but progressingORBMP Power Supply Conditioning  Reminder
                      13.8KV Transformer/Switchgear Replacement

                      Prepare for next week's transformer/switchgear work208V workSchedule for power outage and switch to generator 0700 to 1200 for electrical work and switch over to generator This will affect BWT, BWG, MuCool and Booster Tunnel  Pbar  On Schedule
  New Pbar Target Assembly
 Main Injector

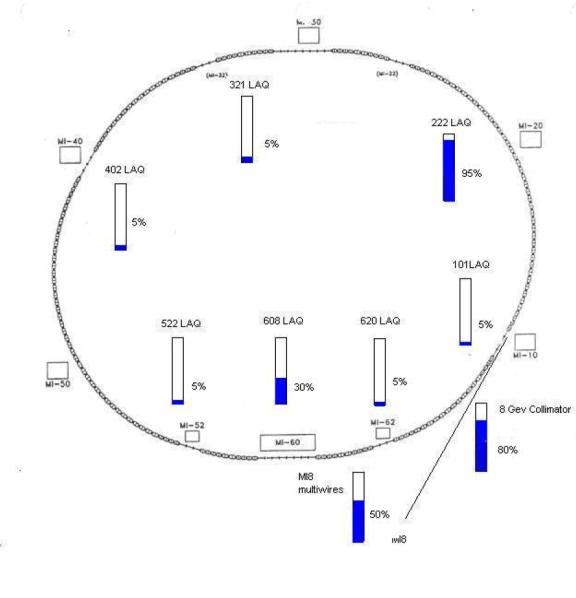

                      Continued installation of new MI8 line multiwires.Continued installation of MI8 collimator.Continued installation of MI10 kicker cooling system.Continued installation of a large aperture quad at 222.
 Began installation of a large aperture quad at 608.Began installation of a large aperture quad at 620.
  Recycler

 The major work is on the Flying Wire vacuum. The Stochastic Cooling Tank work has been dropped.
  Tevatron  Progress

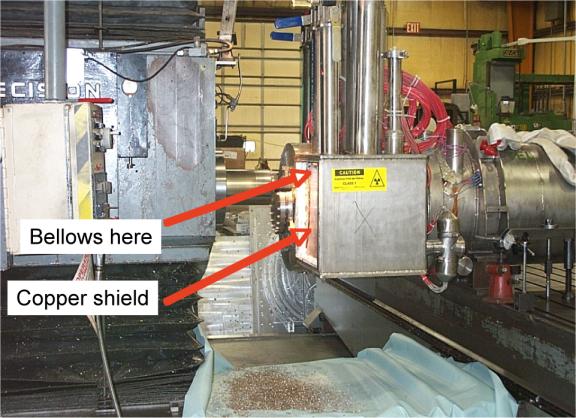

                      F4 and A3 vacuum work done, walk through complete todayA 49 separators installed and under vacuum need to do power test before bake

                      B48 separator installed needs alignmentC0 HLS system doneD0 HLS system needs final testShimming on schedule in F sector skipped 11 magnets in E-2 to make way for vacuum workTEL 2 in place TEL 1 at VMS getting cut open

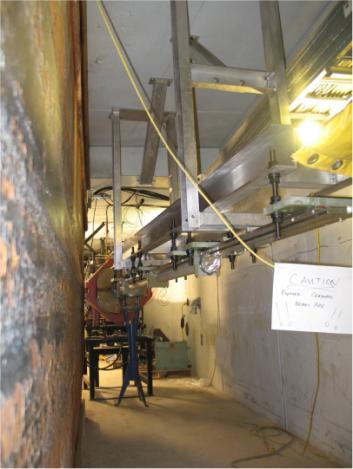

                      E2 found one bad bellows and one bad seal finish next week

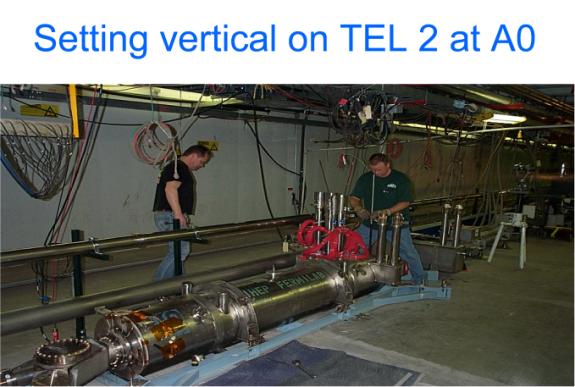

  SwitchYard Still planning the installation of a new quadrupole at A0  NuMI
                      Target Hall Crane Hoist Brake Again OperationalCompleted More Detailed Map of Horn 2 Residual RadiationDeveloping ALARA Plan for Horn 2 RepairChecked Feet for Horn 1 – Found Not to be LooseCleaned Flaking Nickel Coat from Horn Stripline BlocksTarget Chase Chiller Modifications Progressing at ManufacturerScaffolding Construction for Drip Pan Removal Complete
                        Pan Removal Scheduled for Next Week Drain And Calcite Cleaning Completed in Pre-Target & Target HallTarget Hall Air Damper Replaced – Air Leaks MinimizedBeginning Installation of Fall Protection in Pre-Target
                      NuMI Water System Again Operational
                        Pump Aligned and Miscellaneous PM  MiniBooNE
                      This week: No work scheduled.Test Horn week of April 10:
                        Need LCW.Need enclosure interlocked. Week of May 1:
                        Begin alignment work.Begin RAW system work.  Collider Detector at Fermilab (CDF)
                      Power outage for 480 maintenanceThe power generator had a missing phaseHad power outage earlier this weekOn Schedule D-Zero (D0)
                      Layer 0
                        Reconfigured north end of detector to extract Run IIa beam pipeRemoved Run IIa beam pipe from Collision HallTransport Layer 0 to Collision HallLoad Layer 0 and Run IIb beam pipe into EC north beam pipe Level 1 Calorimeter Trigger
                        Move L1Cal trigger crates from sidewalk to MCH1Continue routing BLS cables to patch panels Level 1 Central Track Trigger

 Mechanical  No Report  Cryogenics  Cryo Operations
                      Tevatron at LN2 temperature and LN2 usage is stable with vendor deliveries. Helium losses are slightly up at 13 kscf/day (1/3-1/2 of normal during TeV operations). A1, A3, and E2 are at room temperature and isolated with LOTO. F4 has been completed by MSD and currently being restored by Cryo Dept with anticipation of final walk-through and sign-off early next week; this house can be cooled down to LN2 temperature without the TEL-1 installed. A3 is also almost completed by MSD; Cryo may epoxy past noted helium leaks on power leads and spool piece conning tower leaks need addressing.Pbar D60 Debuncher vacuum work has been completed by Pbar Dept, thus Cryo personnel will restore helium/nitrogen connections and cool down tanks to LN2 temperature next week.ACNET application programs relating to FRIG operations are being tested on Linux consoles. MCR monitoring cryo operations.  CHL Maintenance
                      General facility maintenance is in progress.CHL Helium Compr “A” cooling tower installation is continuing with anticipated completion by month end; required piping passed pressure test and radiography. Some minor electrical/instrumentation work is left.NRL maintenance is in progress. The IR Booster Compressor was overhauled (one piston rod needed repairs). The TSI Compressor Niagara Intercooler heat exchanger bundles were cleaned, leak checked, and over a dozen leaks were fixed with brazed patches; plans are to reinstall the Intercooler next week. Estimate return of plant back to service is after the April 3 MSS power outage.Helium Coldbox-2 controls upgrade is in progress.   FRIG Maintenance
                      Ring-wide overhauls of wet expanders in progress with 13/24 completed.Tevatron Cryogenic Transfer Line E4-F1 air-to-vacuum leak at F1-end bellows was repaired successfully. However, two plate relief valves (D4-E1, A1-A2) on the TRL LN2 circuit were lifted and thus required depressurizing and thawing for resealing.Five IHI cold compressors were removed for inspection and are being overhauled.Various FRIG bldg vacuum maintenance and instrumentation repairs (e.g. lost charge on VPTs) are in progress, as well as support work on houses at room temperature and other equipment as things fail even during the shutdown period.Various Mycom compressor maintenance is in progress: leak hunting and general repairs, F0#1 compressor replacement, F0#3 motor starter replacement Facility Engineering Services No Report  Instrumentation Work continues.  RF Work continues. Controls The database will be down on Saturday, March 25 ES&H Upgrades  Safety System Upgrades
                      Data Acquisition System 95% Complete
                        16 of 17 Linux Ethernet Port Replicator (LEPR) chassis installed Booster 40% Complete
                        Remove RDF Area Booster Dump Move Configuration Changes Main Injector 15% Complete
                        Lower Level Controlled Access Displays ReplacedMain Injector Coasting Beam System changesLam10 Critical Device Interface Installation
                      P-Bar Source 60% Complete

                        Radiation Monitor Card ReplacementSafety System Power Supply ReplacementInterlock New BSC700 Beam Stop

                        Moving location of both Tevatron Coasting Beam Gate Valves
                      MT6 Section 1 & 2 30% Complete

                        Complete Enclosure Interlock System Upgrade
                      Safety System Testing 0% Complete

                        All areas need to be re-tested before startup.

                        ~3.5 R total dose for the first 3 weeks of the shutdown.Reminder to get weekly dose cards or electronic dose recording turned in on Monday’s. EE Support No Report Shutdown Schedule for March 24 through to March 31
 Alignment
                      Tevatron
                        Completed A49 SeparatorsCompleted Rough Align TEL IICompleted Bypass Alignment (TEL II) (Miscellaneous Components)Completed 40% UnrollsCompleted Tie-Rod Elevation run 50%Scheduled B48 Separators (Today) Scheduled Unrolls Scheduled Deep Rod installation. Scheduled TEL II, TEL I support.  Main Injector
                        Completed Alignment MI 222 Completed MI 321 Quad and adjacent Lambertson Completed MI 521-522 Quad and adjacent Lambertson Scheduled MI 608  Scheduled MI 620  8Gev
                        Completed 4 Collimators at CB836 and CB838. Scheduled " The installation of the MI-8 beam dump will require alignment. Several kickers will be installed, one septa magnet, 1 BPM, 2 Toroids, beam pipe, 1 quad will be moved and two multiwires." P-Bar
                        Completed 90% Elevation runs (Drops are still needed) 400MevRecycler
                        Scheduled 180 Deg. Magnet alignment and beam pipe.
                      MiniBooNECDFLinac
                        Scheduled Align changes to upstream 400 MeV line in Linac enclosure, Q74  MIPP
                        Completed 90% of requested as found.
                      Add Ons
                        Completed as found E21-2Completed as Set E21-2Scheduled Tevatron Unrolls (May bring in second crew)
